Skip to main content

Real-World Workflow Examples

Real-World Example 1: Leave Workflow (Simple)

Here is what a simple, single-step workflow looks like in practice:

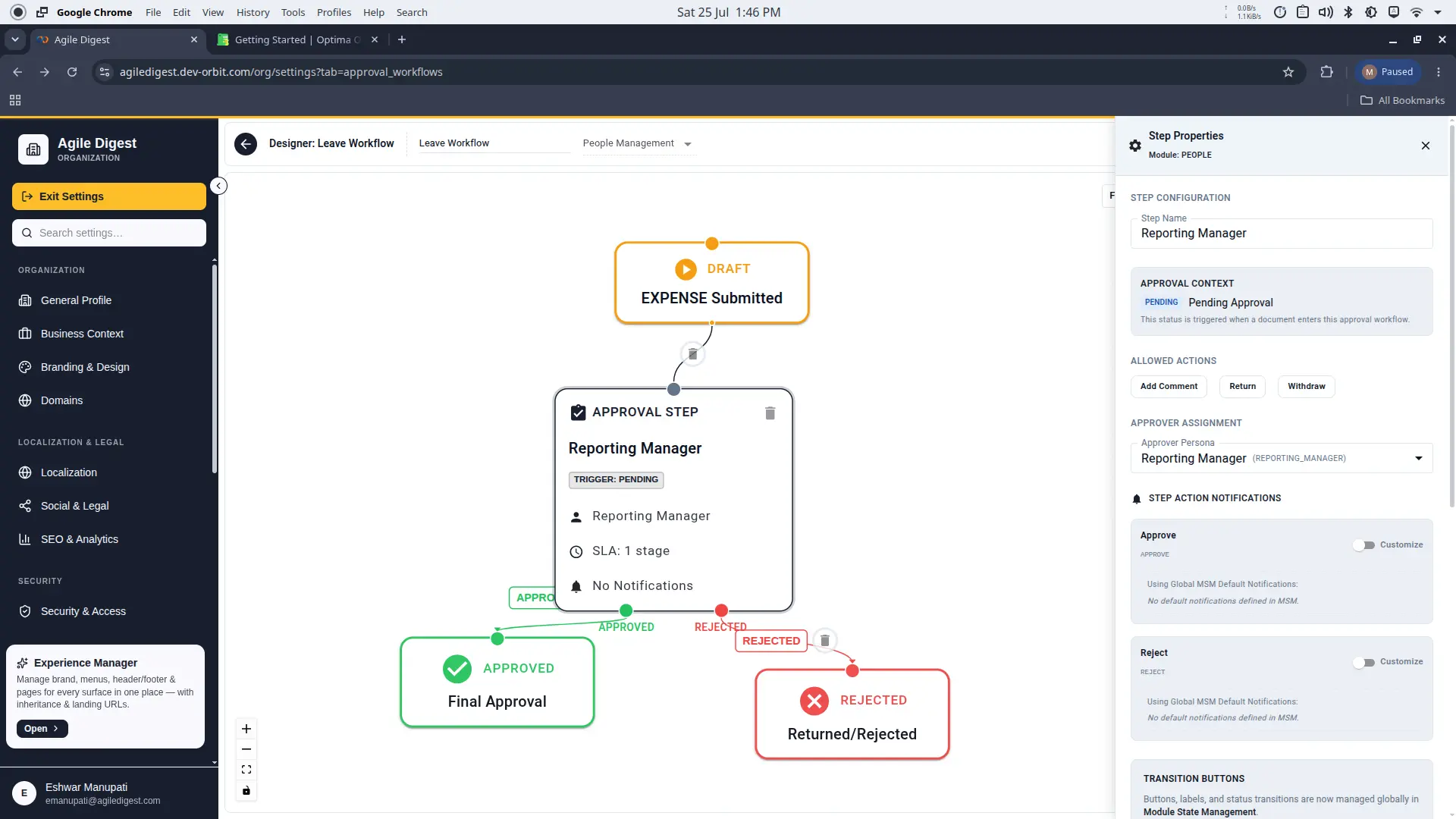

Leave Workflow Designer

  1. An employee submits a leave request → triggers the DRAFT node ("EXPENSE Submitted").
  2. The document enters the Reporting Manager step (TRIGGER: PENDING).
    • The Approver Persona is set to Reporting Manager (REPORTING_MANAGER).
    • SLA is enabled with 1 stage (e.g., auto-approve after 72 hours).
  3. If the Reporting Manager clicks Approve → the document moves to the APPROVED (Final Approval) node.
  4. If the Reporting Manager clicks Reject → the document moves to the REJECTED (Returned/Rejected) node.

Real-World Example 2: Expense Workflow V4 (Advanced, Multi-Stage)

This is a production-ready 4-step expense workflow that demonstrates the full power of the designer. It is marked ACTIVE and LOCKED (because it has live expense requests in progress), so it opens in READ-ONLY mode.

Step 1: Reporting Manager

Step 1 — Reporting Manager

  • Step Name: Reporting Manager
  • Approver Persona: Reporting Manager (REPORTING_MANAGER) — dynamically resolves to the submitter's direct manager.
  • Allowed Actions: Add Comment, Return for Correction, Step Approve, Withdraw Expense.
  • Step Action Notifications:
    • Step Approve fires: Expense Approval Required→Approver and Expense Step Approved→Requestor.
    • Reject fires: Expense Rejected.

Notice the action is Step Approve (not just "Approve"). This is because there are more steps after this one — the system uses STEP_APPROVE for intermediate approvals and reserves APPROVE for the final step.

Step 2: Project Manager Approval

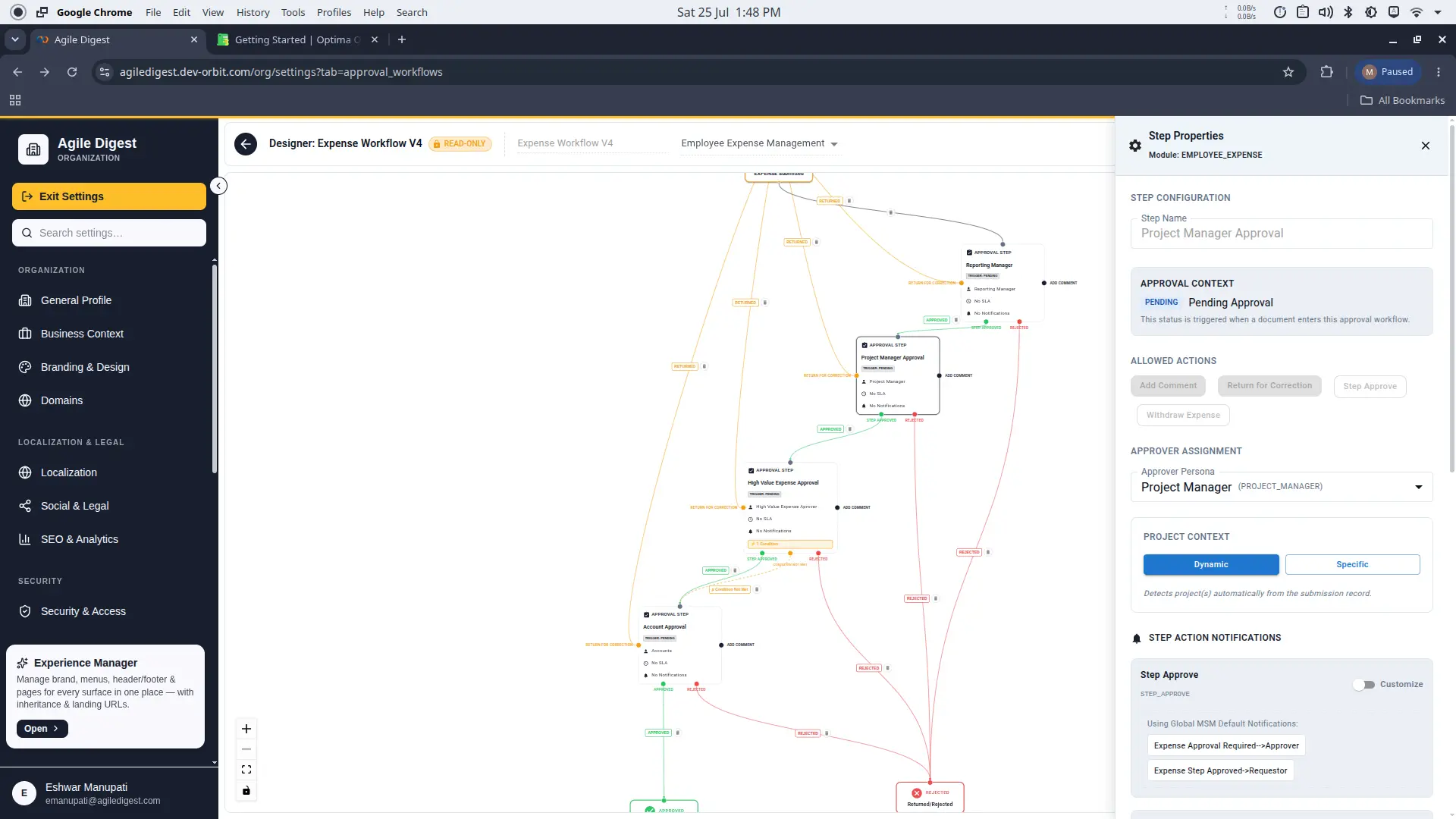

Step 2 — Project Manager

  • Step Name: Project Manager Approval
  • Approver Persona: Project Manager (PROJECT_MANAGER) — resolves to the manager of the project linked to the expense.
  • Project Context: Set to Dynamic — the system automatically detects the project from the submission record. (You can also choose Specific to hard-lock it to a single project.)

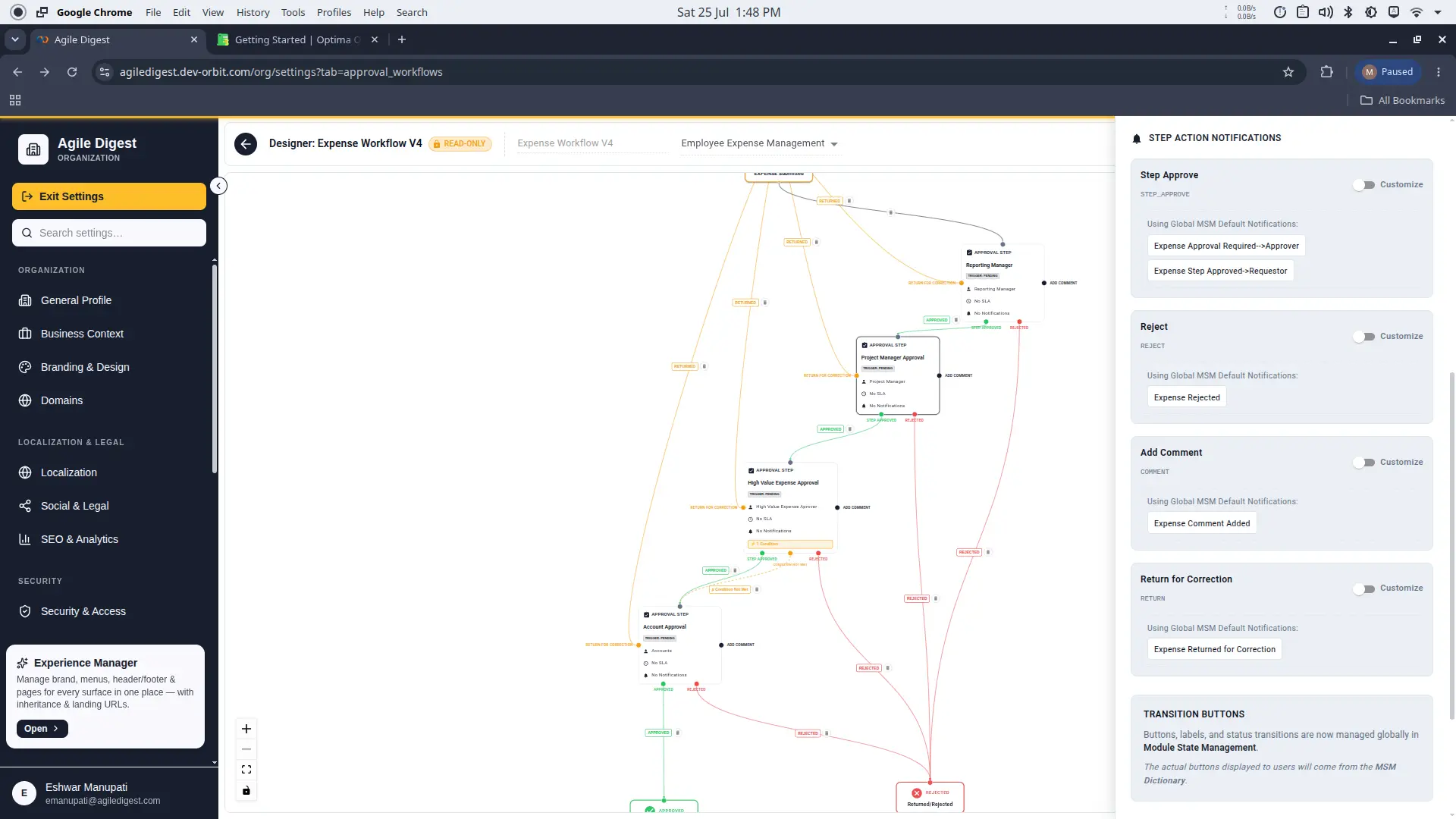

Step 2 — Notification Details

  • All four action types are configured with default MSM notifications:
    • Step ApproveExpense Approval Required→Approver, Expense Step Approved→Requestor
    • RejectExpense Rejected
    • Add CommentExpense Comment Added
    • Return for CorrectionExpense Returned for Correction

Step 2 — Bottom Panel

Step 3: High Value Expense Approval (with Conditional Logic!)

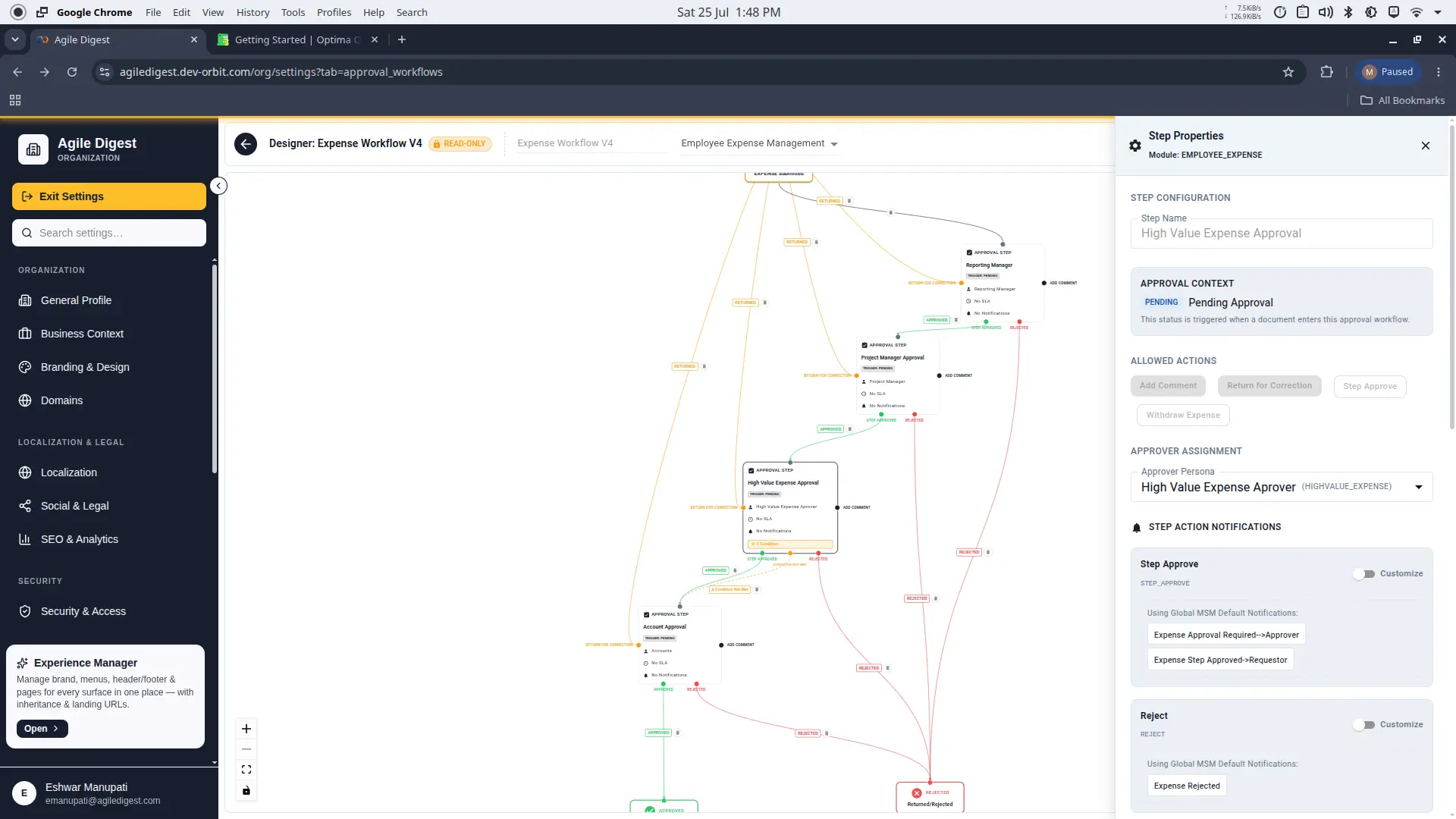

Step 3 — High Value Expense

  • Step Name: High Value Expense Approval
  • Approver Persona: High Value Expense Approver (HIGHVALUE_EXPENSE) — a custom Persona created specifically for large expenses (e.g., a Finance Director or CFO).

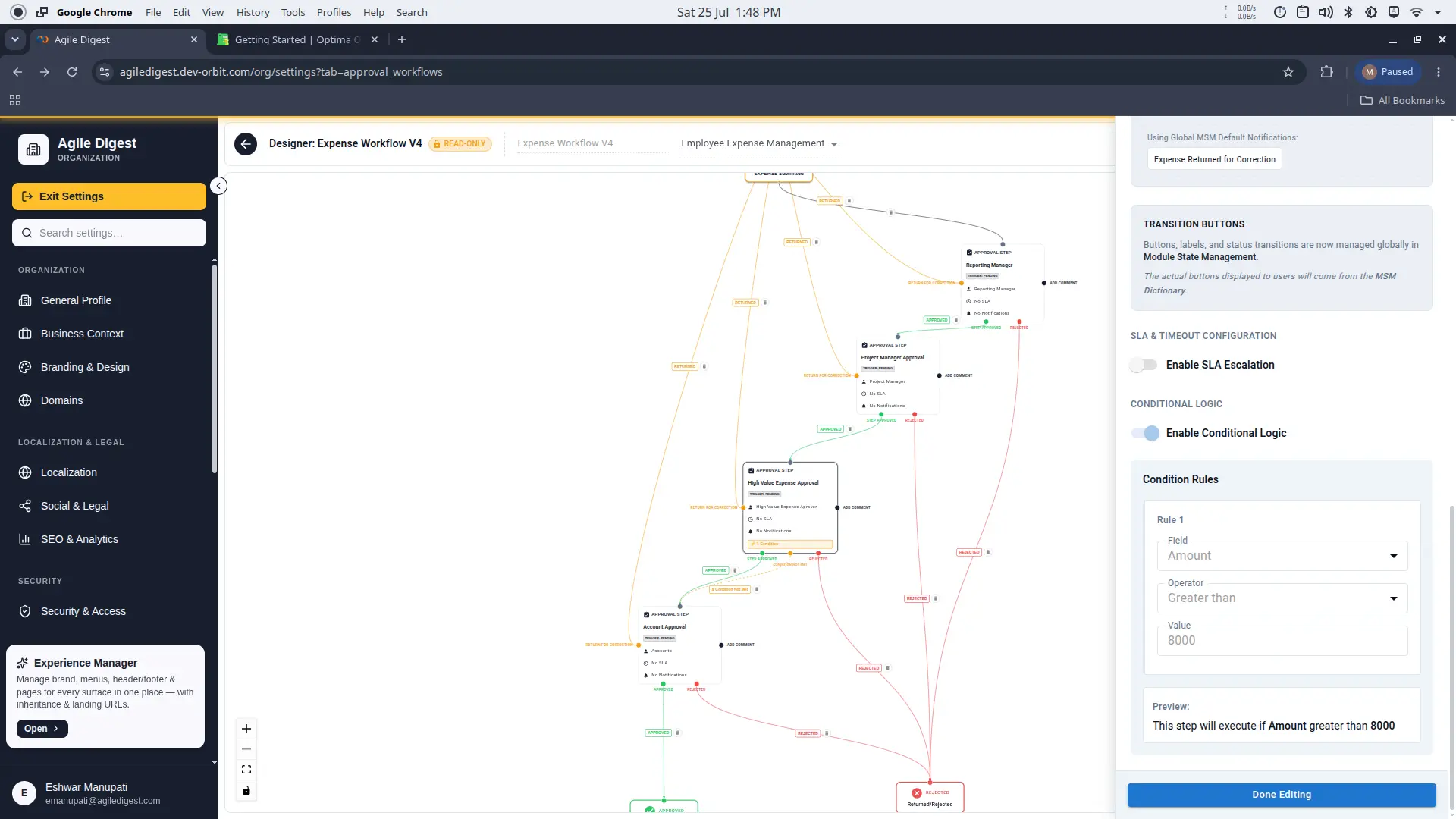

Step 3 — Conditional Logic

  • Conditional Logic is ENABLED with the following rule:
    • Field: Amount
    • Operator: Greater than
    • Value: 8000
    • Preview: "This step will execute if Amount greater than 8000"

This means: If an employee submits an expense of $5,000, this step is skipped entirely and the document goes straight to Step 4. But if the expense is $10,000, the High Value Expense Approver must review it first!

On the canvas, you can see a third outbound connection from this node: CONDITION NOT MET (amber) which bypasses the step.

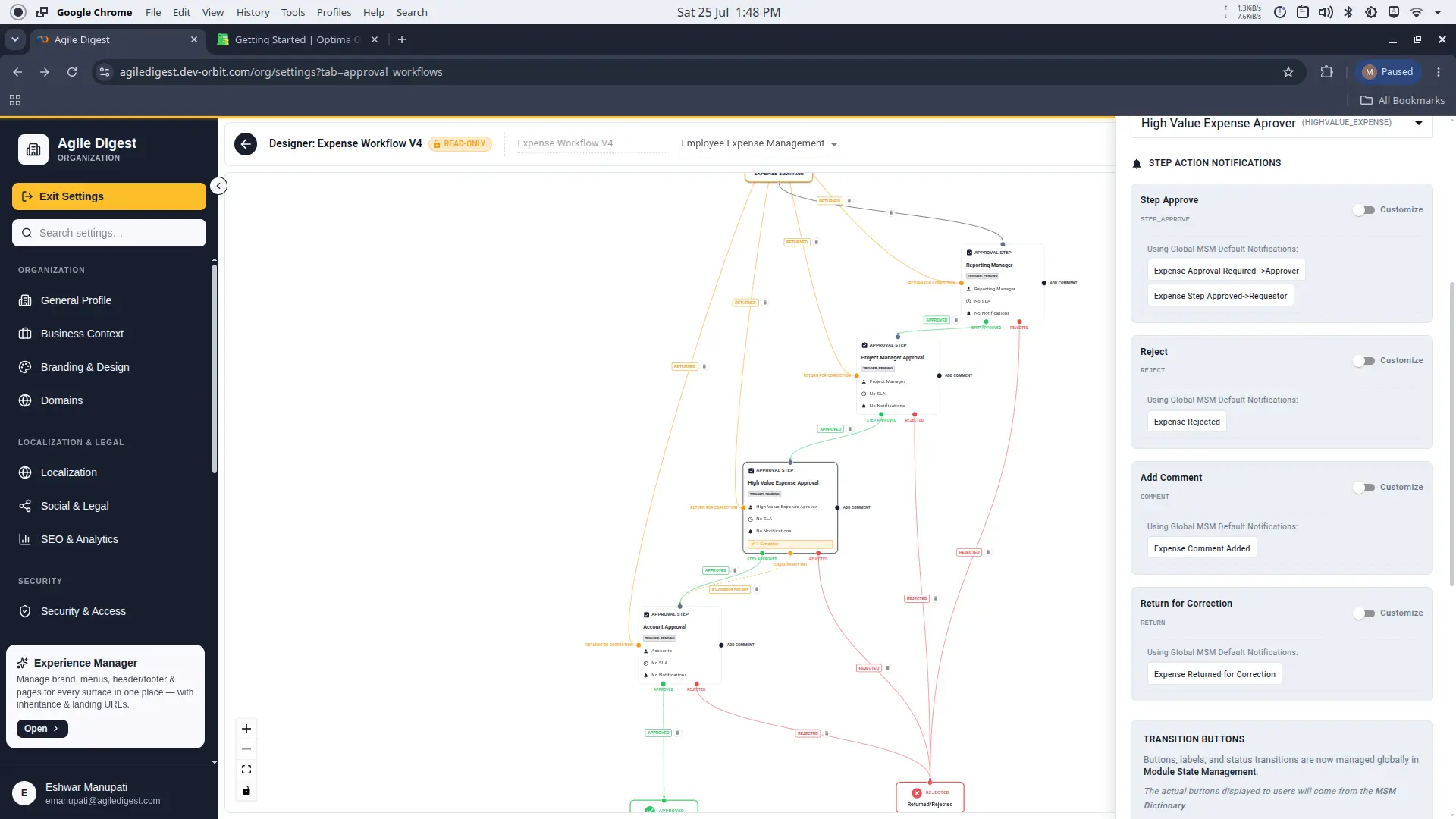

Step 3 — Notifications

Step 4: Account Approval (Final Step)

Step 4 — Accounts

  • Step Name: Account Approval
  • Approver Persona: Accounts (ACCOUNT_APPROVER) — the final gatekeeper. This is a Specific User persona assigned to the Accounts team.
  • Action: This is the final step, so it uses the standard Approve action (not Step Approve). When the Accounts team clicks Approve, the document reaches the terminal APPROVED node.
  • Notifications:
    • ApproveExpense Approved
    • RejectExpense Rejected
    • Add CommentExpense Comment Added
    • Return for CorrectionExpense Returned for Correction

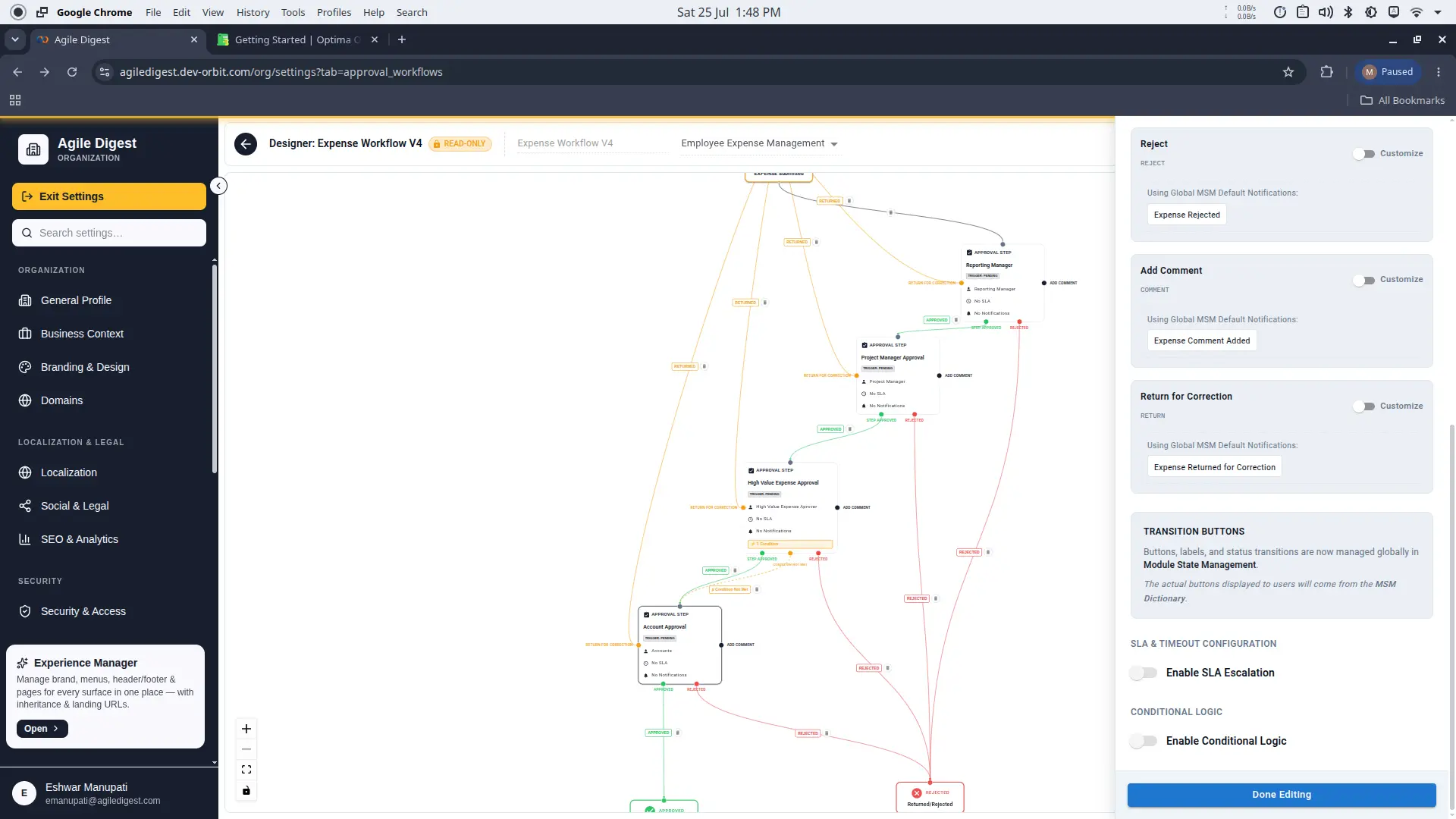

Step 4 — Bottom Panel

The Complete Flow Summary

Employee Submits Expense

Step 1: Reporting Manager (always runs)
↓ Step Approve
Step 2: Project Manager (always runs, dynamic project)
↓ Step Approve
Step 3: High Value Expense Approver (ONLY if Amount > 8000)
↓ Step Approve (or SKIP if condition not met)
Step 4: Accounts (final approval)
↓ Approve
✅ APPROVED — or at any step → ❌ REJECTED
